Every structural team on a Texas project eventually hits the same moment: a post tension slab looks like the logical first choice, then something rules it out. The slab is too thin to drape a tendon. Nobody local can stress on schedule. The owner has a standing policy against PT.

Post-tensioning having limits is not the problem; every system does. The problem is that teams default to conventional reinforced concrete without pricing what the substitution costs in thickness, tonnage, deflection and maintenance.

This guide is a framework for choosing the right alternative when a post tension slab genuinely cannot be used: conventional RC, steel, precast or a hybrid.

Why a Post Tension Slab Is Sometimes Off the Table

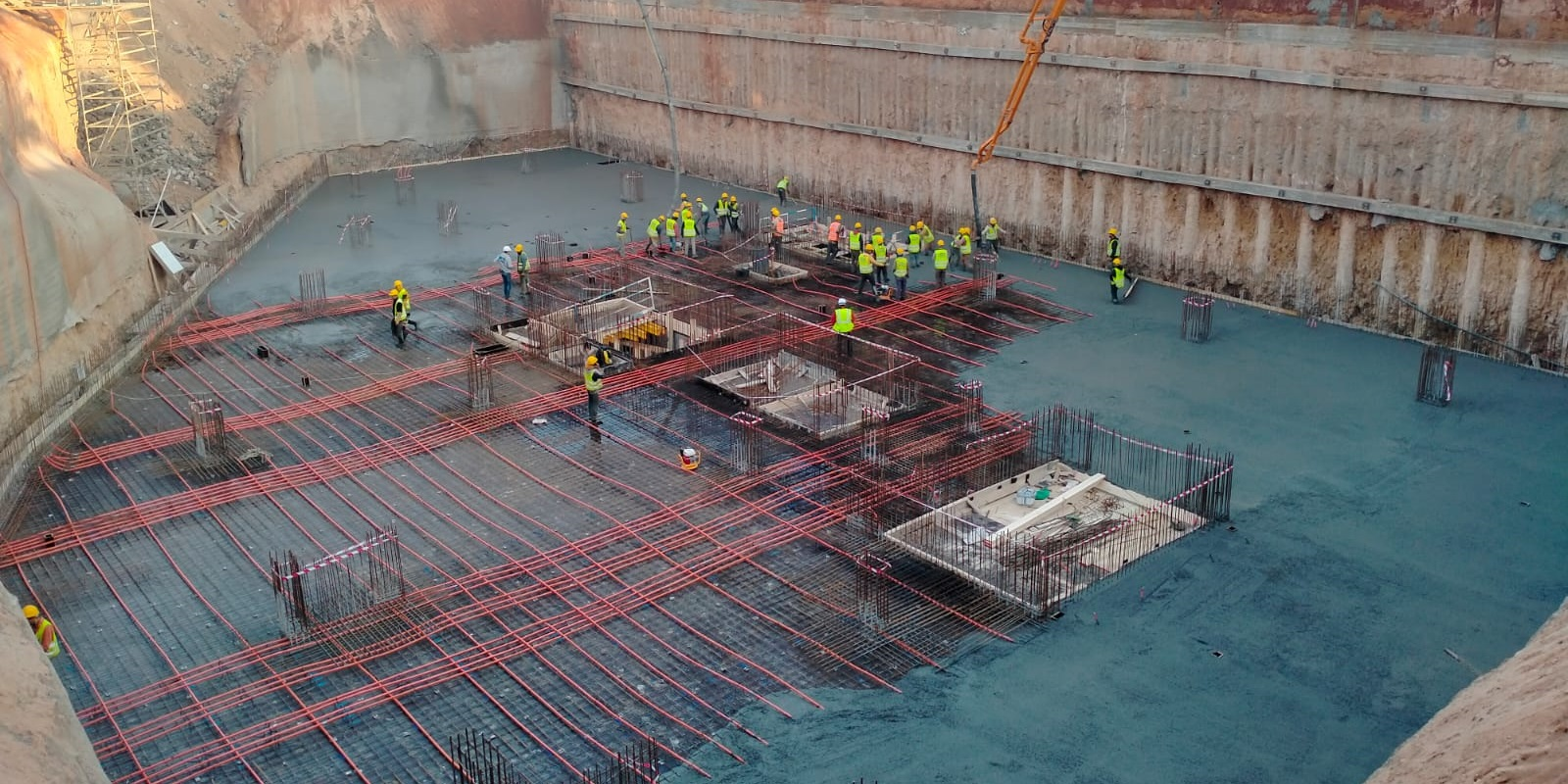

Concrete pump placing concrete over the tendon grid of a post tension slab foundation
A PT pour depends on a stressing crew, a sequence and an inspection plan. When one of those is missing, the alternatives below come into play.

Be precise about why a post tension slab is excluded. In our experience, vague objections such as "too expensive" or "too complicated" rarely survive scrutiny. The constraints that legitimately remove it fall into five groups.

Geometry

A tendon needs room to drape. Cover comes from ACI 318 and, more often, from fire resistance: a Portland Cement Association design article (2005) cites typical 2-hour bottom covers of 3/4 in for restrained interior spans and 1-1/2 in for unrestrained end spans. In a very thin post tension slab, little drape is left, and without drape a tendon balances almost nothing.

Exposure and inspection access

Encapsulation is not the deciding factor: PTI Technical Note 18 (2014) states that all unbonded single-strand tendons in ACI 318 structures must be encapsulated, whatever the exposure. The real question is whether the installation can be inspected and the stressing pockets finished properly. Where that cannot be assured in a chloride environment, a non-PT system may be more defensible.

Crew and schedule

Stressing typically happens a few days after the pour, once the concrete reaches the transfer strength in the specification. The real risk is whether a qualified crew can stress on your cycle; every late visit blocks the shores.

Owner restrictions

Some owners prohibit PT, most often industrial operators who have had trouble with anchor pockets or lack in-house expertise to manage a PT inspection program. Design with that constraint, not against it.

Small or irregular slabs

Fixed PT costs need floor area to spread over. We once pushed PT onto a 4,000 ft2 slab with irregular column spacing, and the savings came out marginal. The full screening logic is in our pillar, post-tension vs reinforced concrete: 6 criteria to choose the right system.

Conventional Reinforced Concrete: The Default Post Tension Slab Alternative

When a post tension slab is out, most teams reach for RC, with good reason: a deep contractor base, a reliable DFW supply chain and a standardized ACI 318 design method.

How it performs against a post tension slab

On a mid-rise residential project in Plano, TX, we compared a PT flat plate with a conventional RC flat slab over the same 26 ft by 28 ft bay. The RC alternative required 9.5 in to satisfy the ACI 318 minimum thickness table, Table 8.3.1.1, against 7 in for the PT design. On that project, the RC option added approximately 180 yd3 of concrete and an estimated 27,000 lb of additional rebar.

Parameter, 26 x 28 ft bayPT flat plateRC flat slab
Slab thickness7 in9.5 in
ConcreteBaselineAbout 180 yd3 more
RebarBaselineAbout 27,000 lb more
Long-term deflectionLoad balanced by tendonsRelies on depth
Specialty crewRequiredStandard

What worked on site

Where PT was genuinely impractical, because of schedule or owner restriction, conventional RC consistently delivered predictable results. The Dallas labor pool knows RC flat slabs well, and the absence of a stressing crew simplifies inspection and QA.

What to watch

Long-span bays above 28 ft in conventional RC consistently produce deflection serviceability problems that are expensive to address after the fact. The extra depth also costs headroom. Bid-level numbers are in PT vs rebar for commercial builders, and houses follow post-tension vs rebar for residential construction.

Structural Steel Framing: Speed Against Long-Term Cost

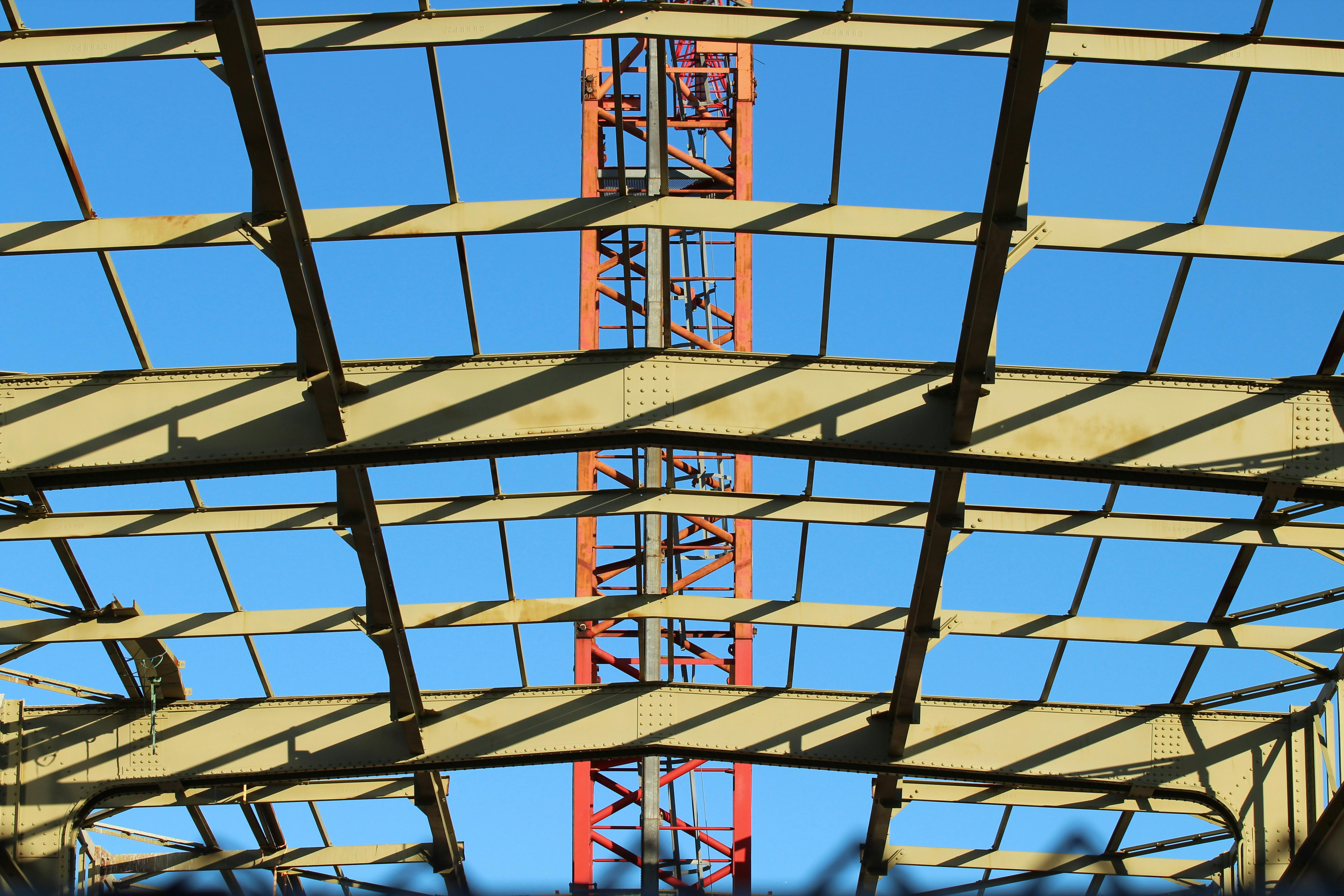

Structural steel frame of girders and beams, an alternative when a post tension slab is not viable
Steel with composite deck trades concrete depth for erection speed, with fireproofing and corrosion protection as separate costs.

Steel is a serious option for mid-rise commercial work when spans of 32 ft and more, fast erection or open floor plans drive the program. Where a composite steel floor comes out shallower than the concrete alternative, the saving in structural floor-to-floor height can add rentable stories within a fixed building envelope; that has to be checked on the actual grid, not assumed.

  • Where steel wins: a frame with composite metal deck and concrete topping gets weather-tight faster than a cast-in-place deck.
  • Where it loses: volatile prices, fireproofing as a separate trade, and corrosion inspection for exposed steel.

Precast Concrete: Factory Prestress, Site Constraints

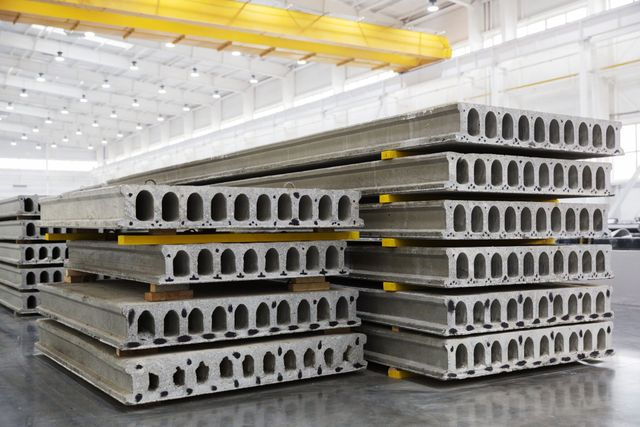

Stacked precast hollow-core slabs in a plant, a factory-prestressed alternative to a post tension slab
Hollow-core planks arrive already prestressed, so the efficiency comes from the plant rather than from stressing on site.

Hollow-core planks, double tees and inverted-tee beams are prestressed in the plant, so precast keeps much of the efficiency of a post tension slab in a different delivery model. According to PCI Gulf South, hollow-core comes in depths of 6 to 16 in with floor span-to-depth ratios of 30 to 40, and double tees run 24 to 34 in deep at ratios of 25 to 35, which puts them in the 60 ft range common in parking.

The limits are logistical: crane reach, haul routes, bearing tolerances and joints. On infill sites in dense Dallas neighborhoods, crane radius and haul route limits have made precast impractical even when it was the structurally superior choice. Less concrete also means less embodied carbon, a comparison developed in the green advantage of post-tensioned slabs.

Hybrid Systems: When No Single Solution Wins

The most defensible designs for complex Texas projects are rarely pure systems. We have designed and reviewed hybrid approaches that combine elements of several. The classic case is a concrete podium with a light frame above: a post tension slab spans the parking bays in the podium, and the lighter superstructure keeps load off the transfer level. The parking economics are in post tension slab ROI for parking garages, and taller frames in PT vs RC slab efficiency in high-rise construction.

Decision Matrix: Matching the Alternative to the Constraint

We use this simplified matrix in pre-schematic reviews to screen out non-starters before design hours are committed. It reflects field observation, not code.

ConstraintConventional RCSteelPrecastHybrid
Spans over 30 ftMarginalGoodGood (one-way)Best
Fast form strippingGoodBestBestVaries
Chloride exposureGood if detailedPoor without protectionGoodVaries
Owner restriction on PTBestGoodGoodGood
Tight urban site, limited craneBestGoodPoorGood
Long-term deflection, spans over 26 ftPoor to marginalGoodGoodBest

Before accepting that PT is "too expensive", test the claim with the method in post tension slab ROI on materials, formwork and timeline.

Get a Second Opinion Before You Switch Systems

The governing code edition and project documents take precedence over this article, and sealing and approval belong to the licensed engineer of record. Our sourcing rules are in our editorial policy.

If a post tension slab has been ruled out on your project and you want to know whether that holds, a technical consultation on slab system selection tests the constraint against the numbers. When a full comparison is needed, our post-tension slab design, optimization and diagnostics services provide it as independent technical support for your engineer of record.
