Concrete is the most widely used construction material in the world, but it is also one of the most carbon-intensive. Cement clinker production accounts for an estimated 7 to 8 percent of global CO₂ emissions, according to the International Energy Agency. For structural engineers and contractors specifying slab systems in Texas, the choice of floor system is no longer a purely structural or budgetary decision. It carries an environmental consequence that is becoming increasingly visible in project requirements.

When a project specifies a conventional reinforced concrete slab without evaluating material efficiency, it is not just leaving structural performance on the table. It is committing to more concrete, more passive rebar, longer formwork cycles, and a heavier carbon load. In a market where embodied carbon documentation is becoming a procurement requirement on more mixed-use and multifamily projects every year, that gap is no longer invisible.

The practical answer is a post tension slab. In this article, we walk through the specific mechanisms by which post-tensioned concrete reduces concrete volume, cuts passive steel consumption, and measurably shrinks the embodied carbon footprint of a structure. These are not theoretical claims. They are outcomes we track against real project data.

~29%
Concrete volume reduction per floor
27.9 T
CO₂ avoided per 10,000 sq ft floor
30–50%
Less passive rebar vs. RC
4 min
Estimated reading time

Why Concrete Volume Is the Core Environmental Variable in PT Slab Design

The environmental impact of a slab system is driven primarily by how much Portland cement it consumes. Cement clinker production is the most energy-intensive step in concrete manufacturing, and the more concrete a design requires, the higher its embodied CO₂. Slab thickness directly controls how much concrete a project places per square foot of floor area.

A conventional reinforced concrete flat plate in residential or light commercial construction in Texas typically runs 6 to 8 in. thick, with the thickness governed by deflection control under ACI 318-19 Table 24.2. A post tension slab, by contrast, actively counteracts gravity loads through the upward equivalent load generated by the curved tendon profile. This allows the structural engineer to reduce slab thickness while still satisfying both serviceability and strength requirements under ACI 318-19 Chapter 8.

In our work on two-way flat plate systems spanning 20 to 30 ft, we consistently observe slab thickness reductions in the range of 20 to 30 percent when transitioning from a conventional RC to an unbonded PT system. That reduction directly maps to less concrete placed per square foot.

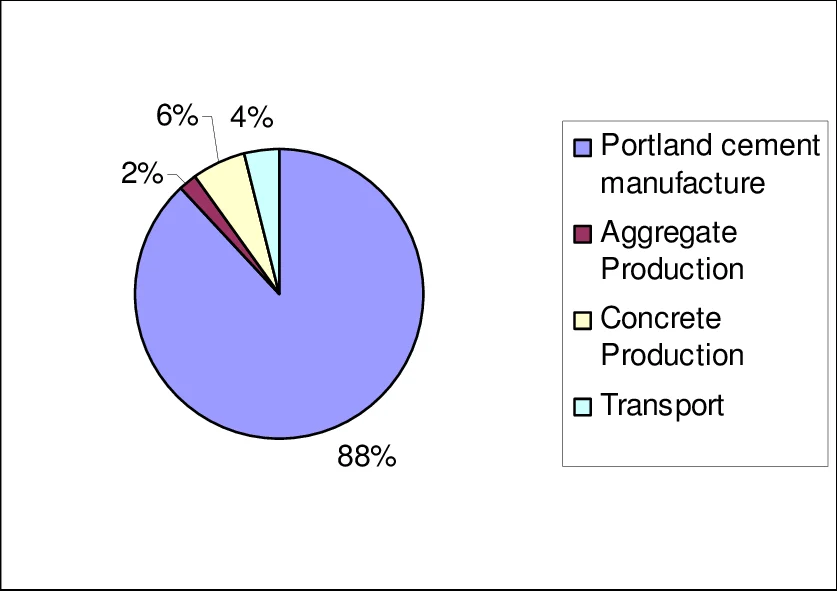

A pie chart showing that 88% of CO2 emissions from concrete come from Portland cement manufacture, illustrating the environmental benefit of reducing concrete volume with a post tension slab.
According to research, approximately 88% of the carbon footprint in concrete is linked to cement production. Utilizing a post tension slab significantly reduces the required concrete volume and overall emissions. Source: ResearchGate — Summary of CO₂ emissions derived from concrete.

Quantifying the Volume Difference: A Worked Example

Consider a single 10,000 sq ft two-way flat plate floor. An RC design governed by deflection might require a 7-in. slab. An equivalent PT design achieving the same spans at the same serviceability level often reaches 5 in. The concrete volume difference is straightforward:

  • RC slab: 10,000 sq ft × (7/12) ft = 5,833 cu ft = approximately 216 cu yd
  • PT slab: 10,000 sq ft × (5/12) ft = 4,167 cu ft = approximately 154 cu yd
  • Volume reduction: approximately 62 cu yd per floor plate

At a representative embodied CO₂ intensity of approximately 900 lb of CO₂ per cubic yard for standard 4,000 psi ready-mix concrete — per the NRMCA Industry-Wide Environmental Product Declaration — that reduction represents approximately 55,800 lb (27.9 tons) of avoided CO₂ on a single floor. Across a three- or four-story structure, the cumulative impact is substantial.

Metric PT Slab RC Slab
Slab Thickness (20–30 ft spans) 5 in. (approx.) 7 in. (approx.)
Concrete Volume (10,000 sq ft floor) ~154 cu yd ~216 cu yd
Volume Reduction ~29% Baseline
Estimated CO₂ Avoided* ~27.9 tons/floor Baseline
Passive Rebar Reduction 30–50% Baseline
Formwork Cycle Duration Shorter Longer

* CO₂ estimate based on approximately 900 lb/cy for standard 4,000 psi ready-mix concrete per the NRMCA Industry-Wide EPD. Values are approximate and project-specific. Verify against project-specific EPD data before publishing in a carbon report.

Reduced Passive Steel: The Second Carbon Lever in Post-Tensioned Concrete

Post-tensioned systems do not eliminate mild reinforcing steel. Per ACI 318-19 Chapter 8, passive rebar is still required for crack control at column strips, punching shear reinforcement, slab edges, and code-minimum shrinkage and temperature steel per Section 24.4. However, the quantity of passive rebar drops significantly compared to a fully reinforced conventional slab because the PT tendons carry the primary flexural demand.

Steel production is among the most carbon-intensive manufacturing processes globally — crude steel production generates approximately 1.85 metric tons of CO₂ per ton of steel, according to the World Steel Association. Reducing rebar consumption compounds the CO₂ savings already achieved through reduced concrete volume. In our experience with unbonded PT flat plates, passive rebar densities run approximately 30 to 50 percent below what an equivalent RC design would require on the same floor plan.

What Did Not Work Without Early Coordination

The material savings only fully materialize when the PT design is coordinated with the concrete mix design before the pour schedule is set. On one project, the specified mix was a standard 4,000 psi design with a target 28-day strength. PT stressing operations require a minimum compressive strength at the time of stressing, typically 3,000 psi per ACI 318-19 Section 26.10. A slower-gaining mix without an accelerated curing protocol pushed the stressing window back by two days, creating a cascade effect on the formwork release schedule. The lesson: specify early-strength verification requirements in the project documents, not as a field conversation.

Code References
Passive steel requirements for post-tensioned slabs are governed by ACI 318-19 Sections 8.6 (flexural reinforcement limits), 8.7 (structural integrity), 22.6 (punching shear), and 24.4 (shrinkage and temperature). Transfer strength requirements are covered by Section 26.10. The PTI DC80.3 standard provides supplemental guidance on stressing timing and minimum concrete strength at transfer.

Shorter Formwork Cycles and the Construction-Phase Carbon Case

A complete embodied carbon analysis of a slab system cannot stop at material quantities. Construction activity generates carbon through equipment fuel burn, worker transportation, and the extended use of temporary materials including formwork panels and shoring frames. Cycle time matters.

A post tension slab is typically stripped and reshored earlier than an equivalent RC slab because the prestress force is applied as soon as the concrete reaches minimum stressing strength, often 3 to 5 days after casting depending on mix design and curing conditions. Earlier stressing enables earlier formwork release, which reduces:

  • Total formwork material consumption per floor cycle on multi-story projects
  • Fuel and equipment hours for crane-assisted forming and stripping operations
  • Overall construction schedule duration, which has indirect energy and carbon implications for the full project team

On a four-story mixed-use structure, the difference between a 14-day and an 18-day floor cycle represents weeks of reduced construction-phase activity. That is not a marginal efficiency gain. It is a trackable carbon reduction with real schedule and cost implications. The U.S. Green Building Council increasingly recognizes construction-phase impacts in whole-building Life Cycle Assessment methodologies under LEED v4.1.

Post-Tension Slabs and Green Building Certification

LEED v4.1 Materials and Resources credits directly reward embodied carbon reduction. The MR Credit: Building Life-Cycle Impact Reduction and the Environmental Product Declaration pathway under MR Credit: Building Product Disclosure and Optimization are two areas where PT slab design can contribute a quantifiable credit-eligible reduction.

If the structural engineer documents volume reductions and material substitutions through a whole-building Life Cycle Assessment (LCA), the PT system becomes a traceable line item in the project's sustainability scorecard. This is increasingly relevant for mixed-use and multifamily developers in Dallas and the broader DFW market pursuing LEED Silver or Gold certification on projects where the structural system accounts for a disproportionate share of total embodied carbon.

LCA tools compatible with the USGBC methodology include Tally and GaBi, both of which can model the concrete and steel quantity differences between PT and RC slab systems when fed accurate structural takeoffs.

Related Analysis

The material efficiency advantages of a post tension slab are one part of a broader structural comparison. For a complete analysis of when post-tensioned design outperforms conventional reinforced concrete on both structural and economic grounds, see our detailed breakdown: Post-Tension vs. Reinforced Concrete: When Does PT Win the Structural Battle?

Frequently Asked Questions

Does a post tension slab always use less concrete than a reinforced concrete slab?

In most two-way flat plate and flat slab applications spanning 20 ft or more, yes. The active load-balancing from the tendon profile allows for thinner slabs at equivalent serviceability levels. In short-span or heavily loaded systems, the thickness difference may be minimal. This evaluation should always be performed on a project-specific basis before drawing conclusions.

Does reducing slab thickness affect fire resistance compliance?

Yes. IBC Table 722.5.2 and ACI 318-19 Table 20.6.1 specify minimum slab thicknesses and cover requirements for fire endurance ratings. In a PT slab, cover to the PT tendons must also satisfy fire endurance requirements. These checks are mandatory when reducing slab thickness for material efficiency and must be addressed in the structural documents.

Can a PT slab contribute to LEED certification credits?

It can contribute to LEED v4.1 Materials and Resources credits, specifically through embodied carbon reduction demonstrated via Life Cycle Assessment documentation and Environmental Product Declarations for the materials used. It does not automatically qualify without the supporting LCA data prepared by a qualified professional.

How much passive rebar does a typical unbonded PT slab save compared to a conventional RC slab?

This depends on span, loading, and system geometry. In our experience with two-way flat plates in the 20 to 30 ft span range, passive rebar quantities in PT slabs run approximately 30 to 50 percent below equivalent RC designs.

Is post-tensioned concrete being specified on green projects in Texas?

Yes. PT concrete is increasingly specified on mixed-use and multifamily developments in Texas where floor plate efficiency and material reduction are part of the project's sustainability strategy. The combination of thinner slabs, reduced passive steel, and shorter construction cycles makes it a practical fit for projects pursuing LEED or other green building frameworks in the Dallas and Houston markets.

Work With TensionOne on Your Next PT Slab Project

Getting the material efficiency and sustainability case right starts with the structural design package. If your project needs a complete PT slab package — including tendon layout plans, calculation notes, and material efficiency analysis for LEED documentation — we can help.

Need PT Slab Drawings and Calculation Notes?

At TensionOne, we provide freelance preparation of drawings and calculation notes for post-tensioned slabs, from residential PT foundations in Dallas to commercial podium decks and mixed-use structures statewide. Every deliverable is built on the same field-tested standards reflected in this article.

Request a Freelance Assignment

External references: IEA Cement Sector Data for global CO₂ emission estimates. NRMCA Industry-Wide EPD for ready-mix concrete embodied carbon benchmarks. World Steel Association for steel production CO₂ intensity data. ACI 318-19 is available from the American Concrete Institute. PTI DC80.3 is available from the Post-Tensioning Institute. LEED v4.1 rating system documentation is available from the U.S. Green Building Council. CO₂ distribution in concrete sourced from ResearchGate peer-reviewed research.

This article is intended as a technical reference and does not constitute a PE-stamped engineering opinion or project-specific structural recommendation. All design decisions should be reviewed and approved by the licensed engineer of record for your project.
